Implementing a CMMS: A Guide for Maintenance Teams
The order to roll out a CMMS in: an owner, the structure and data, roles, training by group, paper, and the first weeks after go-live.
The order to work in
Settle each step in order before you start the next.
| Step | What it settles |
|---|---|
| 1. Name an owner | Who keeps the system right after go-live, and who champions it in each crew and site |
| 2. Take a baseline | How the work runs today, in figures you can compare against after go-live |
| 3. Set the structure | The asset hierarchy, naming, equipment classes, and work order statuses, with one owner for each status |
| 4. Clean the data | Which assets stay. Retired assets are removed before anything is loaded |
| 5. Load the data | Locations and categories first, then assets. The asset template offers both as dropdowns |
| 6. Set up roles | Who opens, assigns, closes, and reads reports, and what each role sees |
| 7. Start with corrective work | Corrective work orders first, then preventive maintenance, then requests |
| 8. Train each group | Administrators, power users, end users, and managers, hands-on, before go-live |
| 9. Run a pilot | One crew or one site on the system before everyone |
| 10. Decide about paper | Whether paper stops at go-live, or stays for jobs where a device is impractical |
| 11. Hold the first weeks | Who answers questions, where the job aids are kept, and which figures you read each week |
How long a rollout takes
Vendors’ published guides put one site with clean data at a few weeks, and a rollout across several sites at several months. A full rollout, every crew and every module, is put at three to six months. The time goes on the data and the training more than on the software, so a team whose asset list is already clean is at the short end.
Take a baseline before you start
Write down how the work runs today, before anything changes. Without these figures, you can’t show later what the system changed.
- How many jobs a month you know about, and how many of them were written down
- How many PMs were scheduled last quarter, and how many were done
- How long a reported problem waits before someone starts on it
- Your unplanned downtime, if you record it
- What you spent on parts and outside contractors last year
A rough count from the calendar, the call log, and the invoices is enough. Keep the same definitions after go-live.
Name an owner, and keep the data right
Name one person who owns the system after go-live, and one champion in each crew or site to keep encouraging use. Secure senior management’s commitment before the rollout starts.
Budget the owner’s time for administration after go-live, not only for the initial load. That means cycle counts, equipment changes, and decommissioning. When equipment is replaced, decommission its record rather than reusing it.
Set up the hierarchy before you load anything
- Stop the hierarchy where the maintenance strategy stops. Give each motor, gearbox, and pump its own asset number. Do not list PLC I/O cards as assets.
- Use equipment classes. They are among the most useful search and sort fields.
- Use ISO 14224:2016 as the minimum reference for the hierarchy.
- Avoid smart asset numbers. They box you in when the plant expands.
There are two ways this goes wrong. A hierarchy that is too flat puts a SAG mill at the same level as an M20 bolt. The other is spending too long on naming.
Catalog each spare once, not six identical oil filters under six stock numbers.
Clean the data before the import
- Remove retired assets before the upload. When equipment is replaced, decommission its record rather than reusing it.
- Put the equipment tree in order, and record every inventory part in the system before the load.
Map your columns to the import
Map each spreadsheet column to an import column before you upload. FixAhead’s import takes a CSV or Excel file, with a template for clean imports, and checks each row before anything is imported.

| Your spreadsheet column | Import column | Must be filled |
|---|---|---|
| Equipment name | name | Yes |
| Area or building | location | Yes. The template offers your locations as a dropdown |
| Equipment type | category | Yes. The template offers your categories as a dropdown |
| Make | manufacturer | No |
| Model | model | No |
| Description or notes | description | No |
| Custodian’s email | No | |
| Labels | tags | No. Separate several with commas |
| Serial number | none | Not applicable |
The expected columns have no serial number field. Ask a vendor where serial numbers go before you start.
Load locations and categories before the assets
Load locations and categories first, since the asset template offers them as dropdowns. Write the column mapping down, then run the first import of assets.
1. Add a location under Organization
Choose Organization, then Locations. Press Add Location beneath a location to add one inside it, or at the foot of the tree for a top-level location.

2. Name the location
Enter the location’s name in Add New Location, then press Save Location.

3. Add each asset category
Choose Library, then Asset Categories, and press Add Categories. In Add Asset Category, enter the category’s name and press Add Category.

4. Download the import template
On Assets, press Import Assets, then Download Template in the Bulk Import Assets dialog. The template offers your locations and categories as pre-filled dropdowns.
5. Fill in the template
Enter one row for each asset. Name, location, and category are required, and the location and category are picked from the dropdowns.


6. Upload the file
In the dialog, press Select CSV or Excel file and choose your file. The file must be CSV or Excel (.xlsx or .xls), up to 10MB.

7. Check Ready to Import and Validation Errors
Ready to Import says how many rows will be imported and how many will be skipped. Each row with an error is listed under Validation Errors with its row number and is skipped; fix those rows in your file and upload it again.

8. Import the valid rows
With the flagged rows fixed and the file uploaded again, press Import Assets. Import Results shows how many rows were imported and how many failed; press Done to close.

Set roles before go-live
Set each person’s role before the first work order is raised. Check that technicians see the work assigned to them without an administrator adding them to each order. Where they do not, administration can become a staffing cost.

1. Open Add User on the Users page

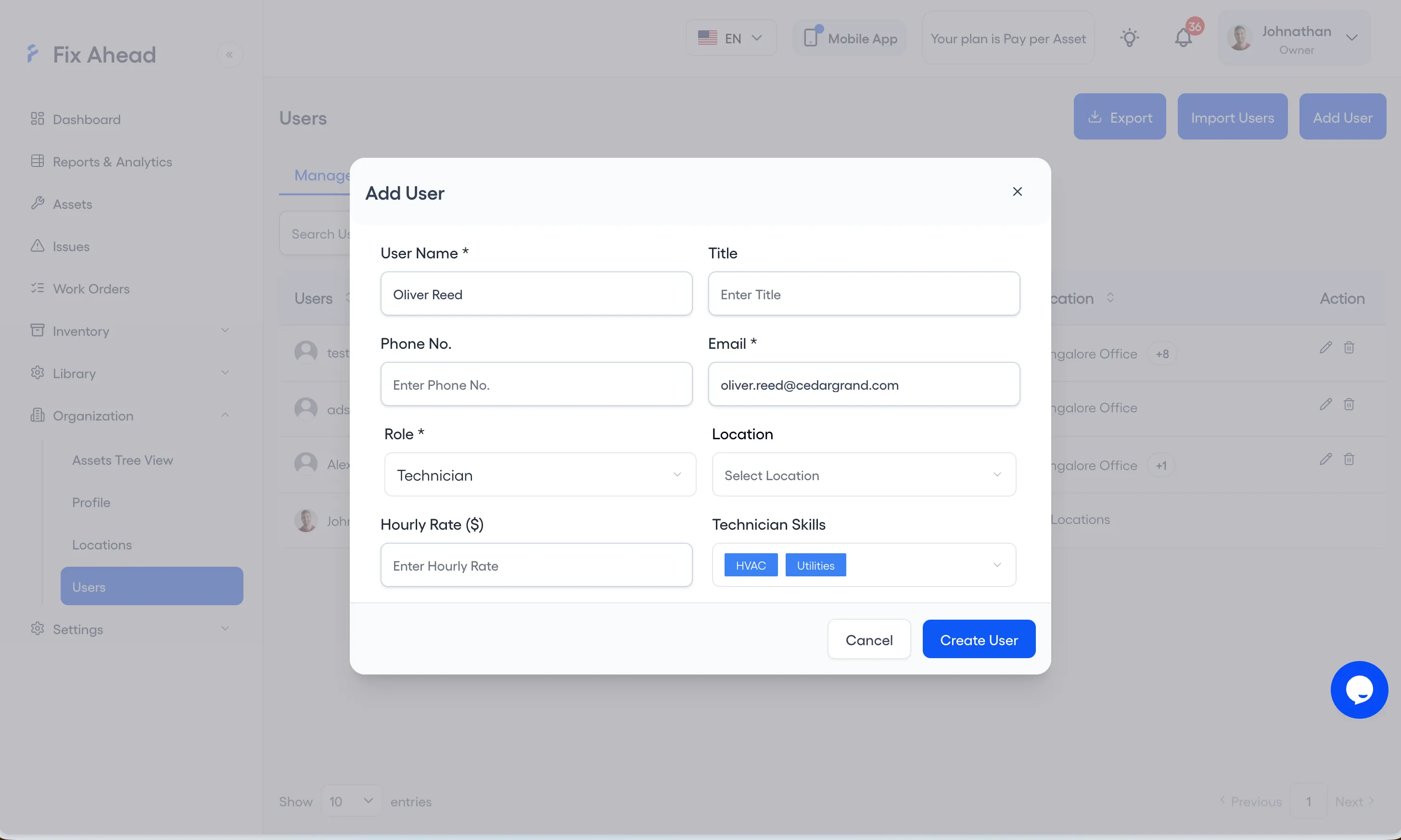

Choose Organization, then Users, and press Add User.
2. Give the person a role
Enter the person’s name and email, and choose Manager, Technician or Member as the role. For a technician, also enter an hourly rate and the skills they hold, then press Create User.

3. Tell the person to sign in
FixAhead sends no invitation when you create the user, so tell the person to sign in with that email.
Train by group, hands-on, and keep training after go-live
Train each group on the work it does. Crews need training on the work-reporting forms and on data entry.
Train hands-on, in a copy of the system the team can practice in. Online modules work as refreshers after that.
Put the training hours in the plan before go-live.
Give each role a short job aid with screenshots. Keep someone available for questions for the first two to three weeks after go-live. For what gets technicians using the system day to day, read how to get the maintenance team to use a CMMS.
Phase the work
Start with corrective work orders. Staff can capture and complete them on their own. Add preventive maintenance once the team is comfortable with corrective work. Release the service-request module last, beginning with the building occupants who already view facilities positively.
Pilot with one crew before everyone
Put one crew, or one site, on the system for two to four weeks before the rest. Choose a crew whose lead wants it, and give them a part of the asset list, not all of it. Fix what the pilot shows, in the structure, the roles, and the job aids, then roll out to the next group.
Build each PM as its own task list
Build each PM as its own task list, rather than copying a master schedule. A copied master schedule is faster to set up, and it can backfire when the equipment is upgraded.
Choose the scope on purpose: one work order for six identical fountains by location, or one work order per asset.
Tag each asset so its record is at the machine
Put a code on each asset that opens its record; scanning it in FixAhead’s Android app opens the asset at the machine. Choose labels that sanitation cannot wash off.
Decide what happens to paper before go-live
Set the paper rule before go-live.
Plan for paper where a device is impractical: a job done with greasy hands, or a technician with no device. FixAhead’s Android app has a glove mode for work gloves and a dark mode for dim spaces, which removes some of the need for paper. Write that plan down, with an end date if paper is to stop.
Require the fields your reports depend on
Make the fields that reports need mandatory in the system, rather than left to memory. Failure codes and downtime on a breakdown are examples to make mandatory. Record all work as work orders, and check each technician’s completion in a regular report.
Read the same figures each week after go-live
Read these every week for the first two months, beside your baseline:
- The share of jobs that arrive as work orders, against the jobs you know were done
- The share of work orders closed by the technician at the job, on the phone
- PM compliance: PMs done on time, divided by PMs scheduled
- How many days a week each person signs in
- How long a reported problem waits before work starts
A figure that stops rising points to the crew or the step to go back to.
Why rollouts stall
- The data went in before it was cleaned, so nobody trusts the asset list.
- Nobody owns the system after go-live, and the first changes never get made.
- Training was one session in a classroom, and the crews never practised their own jobs.
- Everything was configured at once, so the first weeks were spent on settings nobody needed.
- The old way still works: calls, texts, and the spreadsheet stay open beside the new system, and the work drifts back to them.
- The launch had momentum and the weeks after it didn’t, because no one read the figures.
What to ask a vendor
- Which implementation services are included, and which are priced apart: configuration, data conversion and loading, start-up support, training, documentation, and support after go-live. Ask for each one in labor hours.
- What the onboarding and training fees are, and what drives them.
- What the training plan holds for each group: objective, length, format, and total hours.
- Is there a test environment, separate from production, for training?
- Can required fields be enforced for some work orders only, such as a failure code on a corrective one?
- Can each work order status be owned by one role?
- Can technicians see unassigned work without an administrator? How much admin work does reassigning take when someone is away?
- Can we meet the implementation team, not only sales?
- How is support given, in which hours? How are upgrades done, and at what cost?
- Do you provide import templates for assets, locations, PM schedules, parts, and work-order history? Who fills them in, and who loads them?
- Does the import map our columns to your fields, check values before loading, and keep a record of what was loaded?
- Can we run the import again after corrections, with the mapping written down?
- Can existing PM schedules and past work orders come in, or only assets?
- How many levels does the hierarchy allow, and can one asset serve several others, such as a condenser with several heads?
- Are equipment classes and failure codes lists you configure, or free text?
- Can labels be printed for assets and parts, and opened from a phone?
- What happens when a technician has no signal or no device? Can a checklist be printed and closed out later?
- Can we export everything later, in a standard format?
What the rollout costs
Price the services as well as the license, in labor hours, so that the prices can be compared. Budget the data hours before the move, not after it.
Count the hours for the owner, the training, and the weekly administration, as well as the vendor’s invoice. To set a named product beside FixAhead, read FixAhead vs eMaint, FixAhead vs Fiix, FixAhead vs Limble, FixAhead vs MaintainX, or FixAhead vs UpKeep.
Questions teams ask about a CMMS rollout
How long does a CMMS rollout take?
A few weeks for one site whose asset list is clean, and several months across several sites. Most of the time goes on cleaning the data and training the crews.
What does it cost beyond the license?
The owner’s hours, the training hours, the data clean-up, and any services the vendor prices apart, such as data loading or on-site training. Ask for each in labor hours, so that vendors can be compared.
Should we bring our old work-order history across?
Bring the assets, the open work, and the PM schedules first. Keep the old history in its export, where you can still read it, and bring it across later only if a report or an audit needs it.
Who should own the system?
One person who has the time to keep it right after go-live, usually a planner, a supervisor, or the maintenance manager, with a champion in each crew.
How do we stop the team going back to the spreadsheet?
Set a date when the old way stops, make the work order the only way a job gets assigned, and read the weekly figures with each crew lead.
